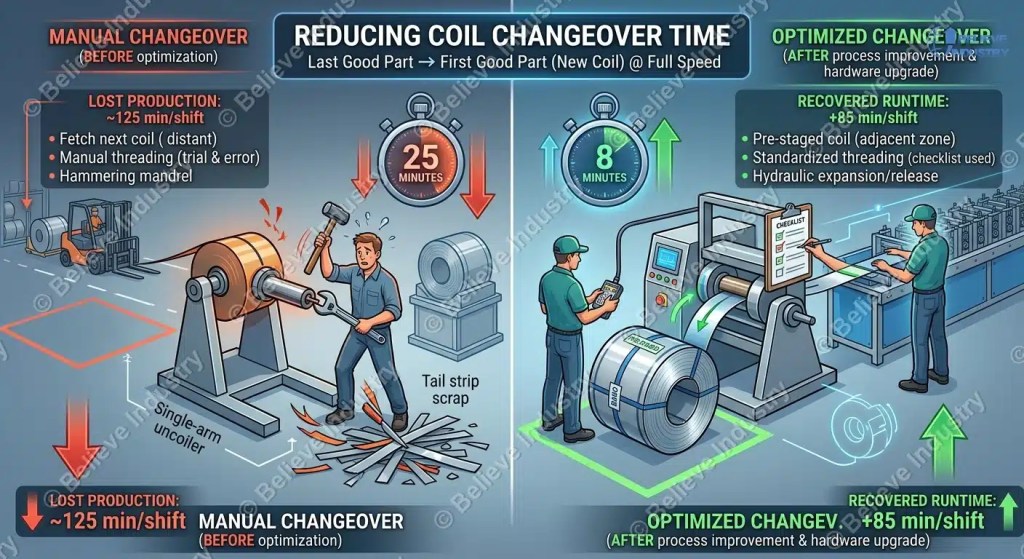

Comparação entre troca manual e otimizada de bobinas

Como reduzir o tempo de troca de bobinas na produção de perfilagem de rolos

What Is Coil Changeover Time?

Coil changeover time is the minutes your roll forming line stands idle between the end of one coil and full production speed on the next. It covers ejecting the old coil core, releasing the tail strip, loading the new coil, threading the head, and ramping back to speed. Most shops never measure it, which is why it quietly eats 60 to 120 minutes per shift.

Coil changeover definition: the total elapsed time from last good part on the outgoing coil to first good part on the incoming coil, at normal line speed. If you count anything less, you are lying to yourself about your downtime.

A typical manual changeover on a single-arm decoiler runs 20 to 30 minutes. A disciplined crew with the right hardware does the same job in 8 minutes. On a line running 3-ton coils, that gap is worth thousands of meters of lost profile every month. If you are new to how the pieces fit together, start with Como funciona uma máquina de perfilagem de rolos, because every changeover step happens at the front of that line.

Why Coil Changeover Time Destroys Profit

The math is simple. A roofing line changing coils 5 times per shift at 25 minutes each loses 125 minutes of production daily. At 15 m/min line speed, that is nearly 2,800 linear meters of panel not made every shift, before scrap from bad threading.

Plants respond by buying a faster roll forming machine line, which is the wrong fix. The cheapest capacity in any roll forming shop hides inside changeover time. Studies of overall equipment effectiveness list changeover among the top three planned losses on coil-fed lines.

Where the Minutes Go: A 25-Minute Baseline

Before you improve anything, record what actually happens. Here is a real-world baseline from a single-arm manual decoiler feeding a C purlin line, filmed and timed over five changeovers:

EtapaMinutesWasted by
Searching for crane or forklift and driver4No pre-staging
Cutting and removing the tail strip5No tail plan
Collapsing mandrel, ejecting the empty core4Worn mandrel, manual hammering
Fetching the next coil from storage5Coil stored far from the line
Loading, centering, expanding mandrel3Manual alignment
Threading the strip head into the leveler4No threading aid, trial and error

Read that table again. About 9 of the 25 minutes are walking and searching, not metalworking. That is why changeover optimization beats buying speed.

Tip 1: Time-Map the Changeover Before You Touch Anything

You cannot reduce what you have not measured. Film three changeovers with a phone, then break them into steps and sort each step into internal (line stopped) or external (line running). This is the core of SMED methodology, and it works on decoilers exactly as it works on presses.

The usual finding shocks shop owners: 40% of changeover time is work that could happen while the line still runs. Fetching the next coil, staging banding cutters, pre-setting the mandrel pressure, printing the job card. Move those off the clock and the internal time shrinks without spending a dollar on hardware. Trade coverage of roll forming productivity reports similar findings across job shops.

Tip 2: Pre-Stage the Next Coil

Coil pre-staging means the next coil sits on a saddle or ramp beside the decoiler, banding cut, eye aligned with the mandrel, before the current coil runs out. It is the single cheapest changeover optimization in this list.

Rules that make pre-staging work:

  • Mark a staging zone one forklift turn from the decoiler, painted on the floor.
  • Cut the coil bands only after the coil is staged, never inside the storage area.
  • Stage coils in production sequence from the linha de corte or warehouse, widest first.
  • Assign staging to the operator during the last 10 minutes of the running coil.

Done right, pre-staging deletes the 9 minutes of fetching and searching from the baseline above. It costs a floor marking and a discipline habit, nothing else. This matters most on multi-profile lines where coil changes are frequent, such as a C Z purlin roll forming machine switching between C and Z widths.

Tip 3: Fix Slow Mandrel Release

Mandrel release is where old lines bleed time. Operators hammer stuck cores, pump the expansion mechanism repeatedly, or pry the coil off with a bar. Every hammer blow risks mandrel damage and worker injury.

Fix mandrel release in this order:

  1. Keep the expansion wedges greased on the schedule in the machine manual, weekly at minimum.
  2. Check hydraulic pressure at the mandrel cylinder against spec, not at the pump.
  3. Add a pneumatic core ejector or hydraulic push-off if the machine allows it.
  4. Replace bent wedge segments immediately, because one bent wedge jams every release after it.

A healthy desenrolador releases a core in under 60 seconds. If yours takes five minutes, maintenance, not manpower, is your problem. Our tipos de máquinas desbobinadoras guide covers the release mechanics of each design in detail.

Tip 4: Handle the Tail Strip with a Plan

The tail strip is the last few meters of the outgoing coil, and untrained crews turn it into theater. One operator chases a flapping strip while another hunts for cutters, and the line sits dead for five minutes.

Write the tail strip procedure down and rehearse it:

  • Cut the tail at the leveler entry, not back at the decoiler, so the scrap piece is short and controllable.
  • Keep banding cutters or a dedicated shear at a marked station within reach of the decoiler.
  • Pull the tail clear with a hook, never by hand, at the moment the coil stops.
  • Drop tails into a scrap bin positioned at the cut point, not on the floor.

Tail strip handling done as a two-person drill takes 90 seconds. Improvised, it takes five minutes and occasionally takes fingers. Treat it as a safety procedure and a speed procedure at the same time.

Tip 5: Upgrade to a Hydraulic Decoiler

Hardware eventually caps how fast a changeover can go. A manual screw-expanded single-arm decoiler demands muscle and time on every coil. A hydraulic decoiler expands and contracts the mandrel at the push of a button and swings the arm out of the loading path automatically.

Decoiler typeTypical changeoverMandrel actionIdeal para
Manual single-arm20 to 30 minScrew expansion, hammer releaseLow volume, budget lines
Hydraulic single-arm10 to 14 minHydraulic expansion and releaseMost roll forming lines
Hydraulic with core ejector8 to 10 minAuto eject, push-offHigh coil turnover
Dual-head uncoiler3 to 5 minSecond head pre-loadedMaximum uptime, two-coil production

UM desenrolador hidráulico upgrade typically pays back inside a year for any line changing more than three coils per shift. For plants that cannot tolerate any stop, a dual-head uncoiler carries the next coil on the second head and changeover collapses to the time it takes to weld or pin the strips together. The difference shows up directly in the price tier of any preço da máquina de perfilagem quote, so decide the decoiler spec before you sign, not after.

Tip 6: Standardize Threading and Run a Checklist

The last chunk of lost time hides in the restart. Each operator threads the strip head their own way, bumps the line, backs up, and tries again. The fix is boring and effective: one written threading standard and one laminated changeover checklist hung at the decoiler.

The checklist should cover mandrel pressure per coil width, strip centering against the scale, leveler gap setting, and the ramp-up speed steps for the profile. Modern conformação de rolos servoelétrica controls store these as recipes, so the correct settings load in seconds instead of being re-derived every coil. Machines built for fast product switches, like the máquina de perfilagem de rolos de troca rápida, extend the same recipe logic to the tooling itself.

Standardization is free, and it is the step shops skip because it feels like paperwork. Film your changeover after one month on the checklist and compare. The video will make the case for you.

6 tips to reduce coil changeover time

Case Study: From 25 Minutes to 8 Minutes

A Middle East purlin producer running two shifts asked us to attack their coil changeover time on a manual single-arm line. We applied all six tips in stages over eight weeks. No new roll forming machine line was purchased, only a hydraulic decoiler retrofit and process discipline.

MétricaBeforeAfterDiferença
Average coil changeover25 min8 min-68%
Changeovers per shift550
Lost production per shift125 min40 min+85 min running time
Extra output per shift0 m~1,900 mAt 22 m/min average
Tail strip incidents2 per month012 months running

The staged sequence mattered. Time-mapping and pre-staging came first and delivered 25 to 15 minutes in week two without hardware. Mandrel service and tail strip drills took it to 12 minutes by week five. The hydraulic decoiler retrofit delivered the final drop to 8 minutes. Spending on hardware first would have hidden the process gains.

Common Changeover Mistakes

  • Buying speed before measuring. A faster line with a 25-minute changeover is still a slow line in real output.
  • Storing coils far from the decoiler. Every meter of forklift travel is a minute of downtime.
  • Ignoring mandrel maintenance. Stuck cores turn a 3-minute release into a 15-minute fight.
  • One-person changeovers on big coils. A 3-ton coil change is a two-person job by procedure.
  • No restart standard. Threading by feel produces scrap at every coil change, and scrap is changeover time in disguise.

Frequently Asked Questions of Coil Changeover Time Reduction

How long does a coil changeover take in roll forming?

A manual single-arm decoiler with no preparation runs 20 to 30 minutes. A hydraulic decoiler with pre-staged coils and a trained crew finishes in 8 to 10 minutes. Dual-head uncoilers cut the swap to under 5 minutes.

What is the fastest way to reduce coil changeover time?

Time-map the changeover and pre-stage the next coil. These two steps cost almost nothing and typically remove 40% of downtime before any hardware is purchased.

What is mandrel release in coil changeover?

Mandrel release is collapsing the decoiler mandrel so the empty coil core slides off. Slow release is usually a lubrication or hydraulic pressure problem, not an operator problem.

How does a hydraulic decoiler speed up changeover?

It expands and releases the mandrel hydraulically at a button press, removes hammering and prying, and often adds a core ejector that pushes the empty core off automatically.

How many minutes of downtime per shift does changeover cause?

At 5 changeovers per shift and 25 minutes each, a line loses 125 minutes per shift. Reducing changeover to 8 minutes recovers 85 minutes of production time daily.

What is coil pre-staging?

Coil pre-staging means positioning the next coil beside the decoiler, banding cut and eye aligned, while the current coil is still running. It converts internal changeover time into external time that does not stop the line.

Is a dual-head uncoiler worth the cost?

If your line changes coils more than six times per shift or runs continuous orders, yes. The second head carries a pre-loaded coil, so the strip change takes minutes and line stoppage approaches zero.

Does changeover optimization also reduce scrap?

Yes. Standardized threading and recipe-based restart settings cut the misfed strip heads and off-spec first pieces that normally follow every coil change.

Final Take

Coil changeover time is the most recoverable loss in a roll forming plant. Measure it, move the fetching and staging off the clock, fix the mandrel, drill the tail strip, then upgrade to a hydraulic decoiler. In that order. The shops that hit 8 minutes are not the ones with the newest machines, they are the ones with the discipline to time-map first.

Believe Industry Company has spent more than 15 years building decoilers and complete roll forming lines shipped to over 20 countries. Tell us your coil weights, changeover count per shift, and current downtime, and we will recommend the decoiler configuration that fits your production floor.

Última atualização: 2026-08-17

Registro de alterações do artigo
– 2026-08-17: Initial publication. Added 25-minute baseline breakdown, six changeover reduction tips, decoiler type comparison, and the 25-to-8-minute case study.

Próximos gatilhos de revisão
– Review if hydraulic decoiler retrofit pricing shifts more than 10% from stated payback assumptions.
– Update the case study numbers after the 12-month follow-up report from the Middle East line.
– Refresh dual-head uncoiler changeover figures when new model specs are released.
– Recheck internal links against the sitemap after any site restructure.
– Add SMED workshop results if a customer documents an 8-to-5-minute changeover.
